Irrigation renewal project
What is happening this week
For the week commencing 07 July 2025:

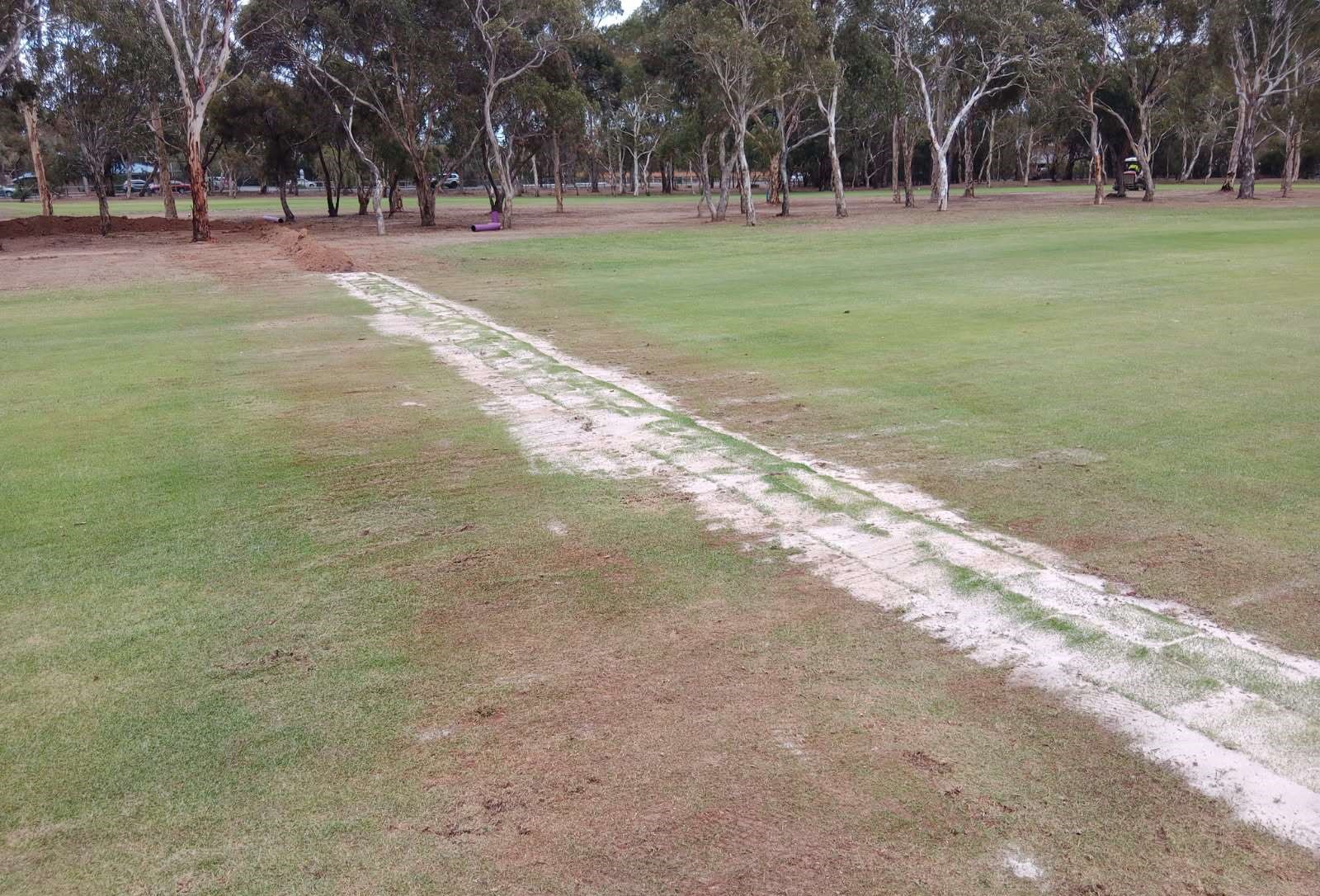

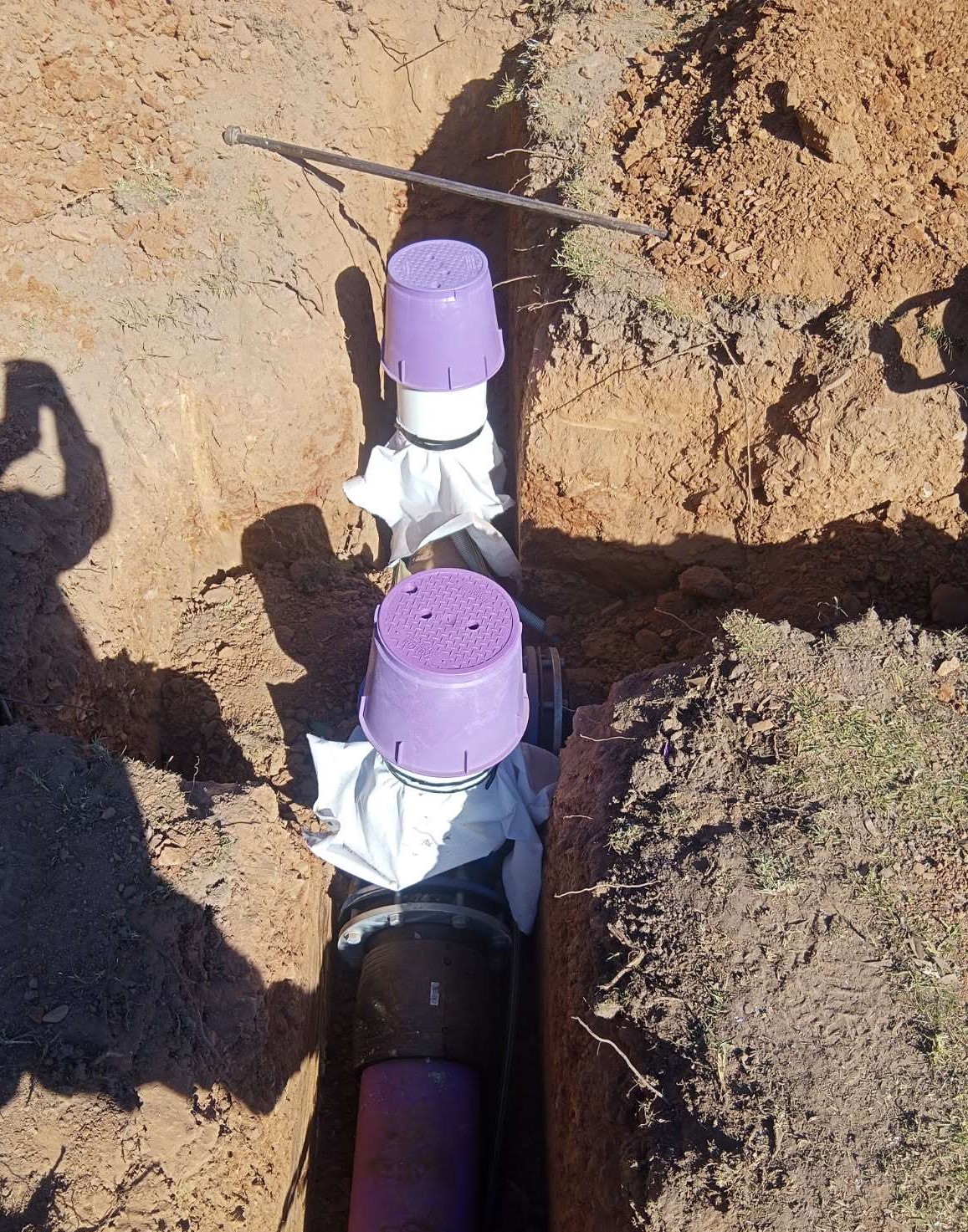

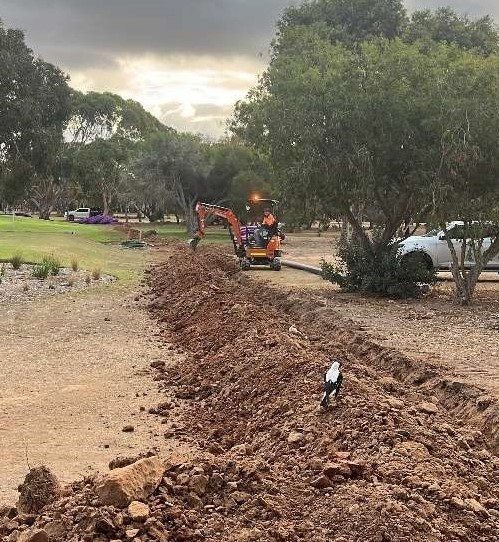

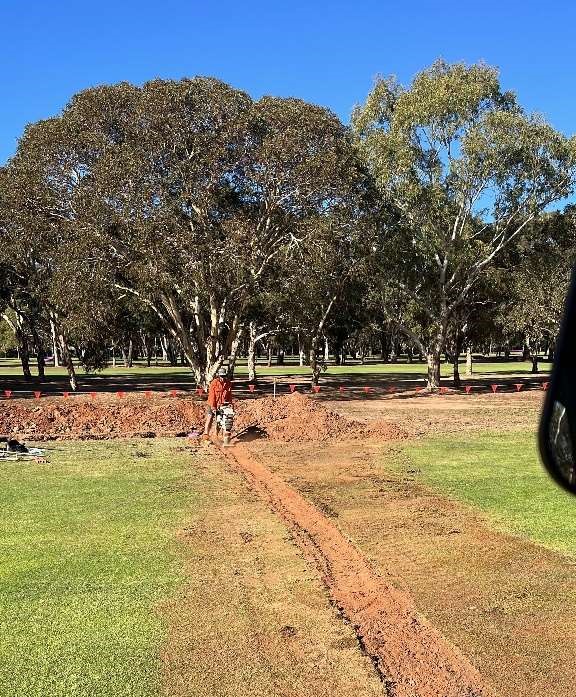

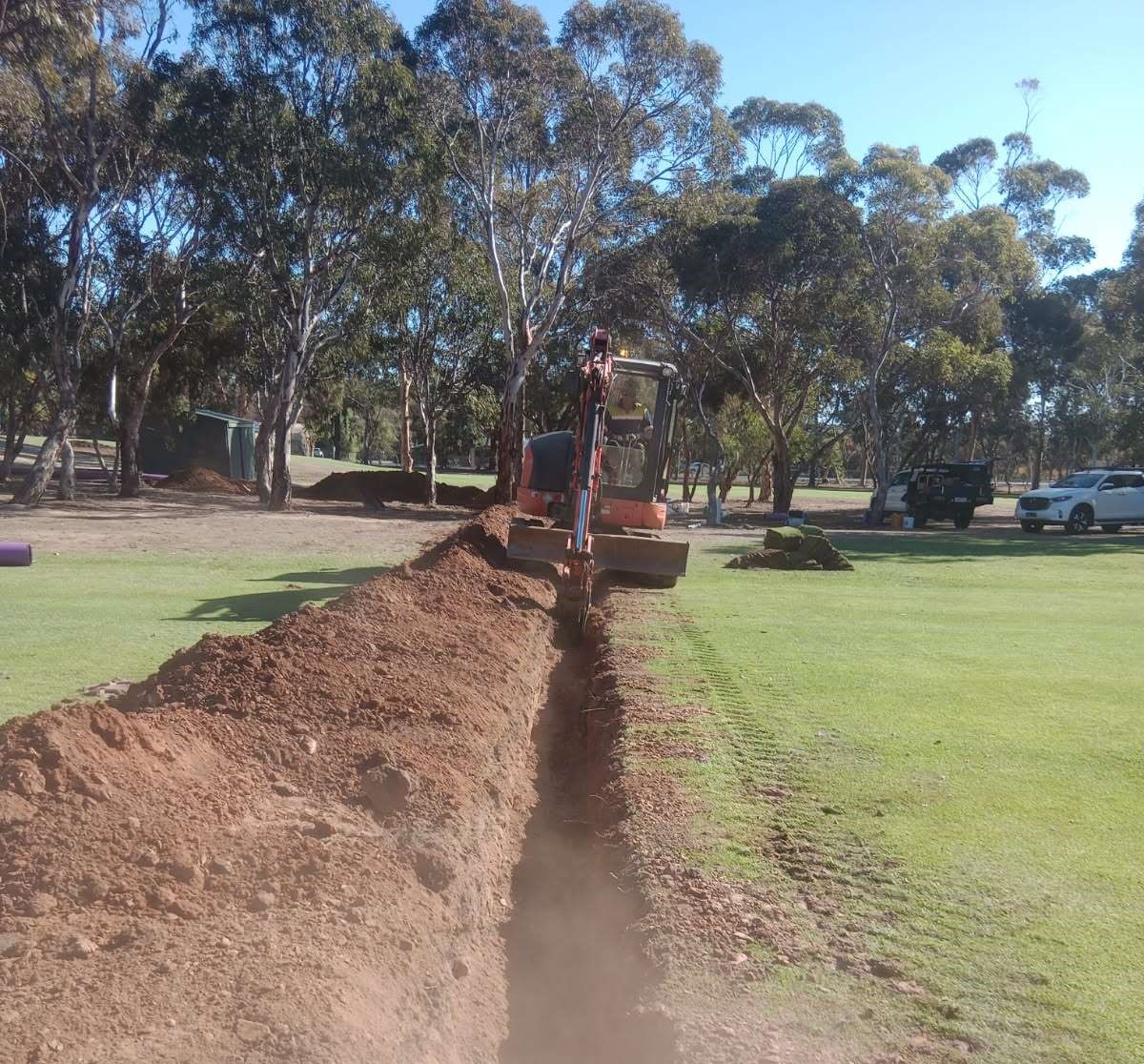

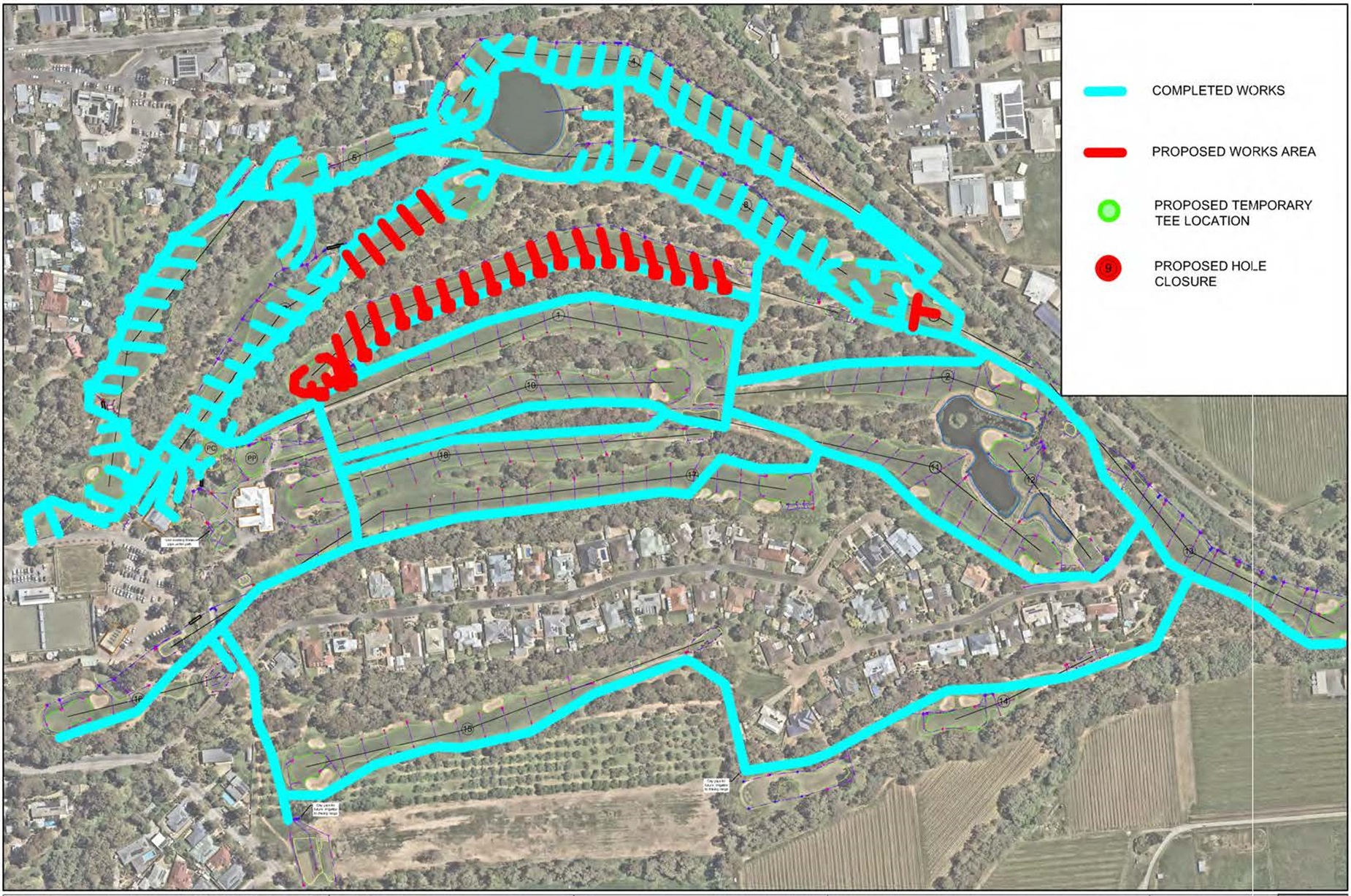

The last mainline connection of the bored pipe work on the western side of Waverley Drive will be plumbed into the 16th mainline, completing all mainline works. Works will then continue with the 5th, 6th and 7th greens and tees able to be installed, and time permitting other works can proceed such as the 8th tee and the nursery on the left of the 7th.

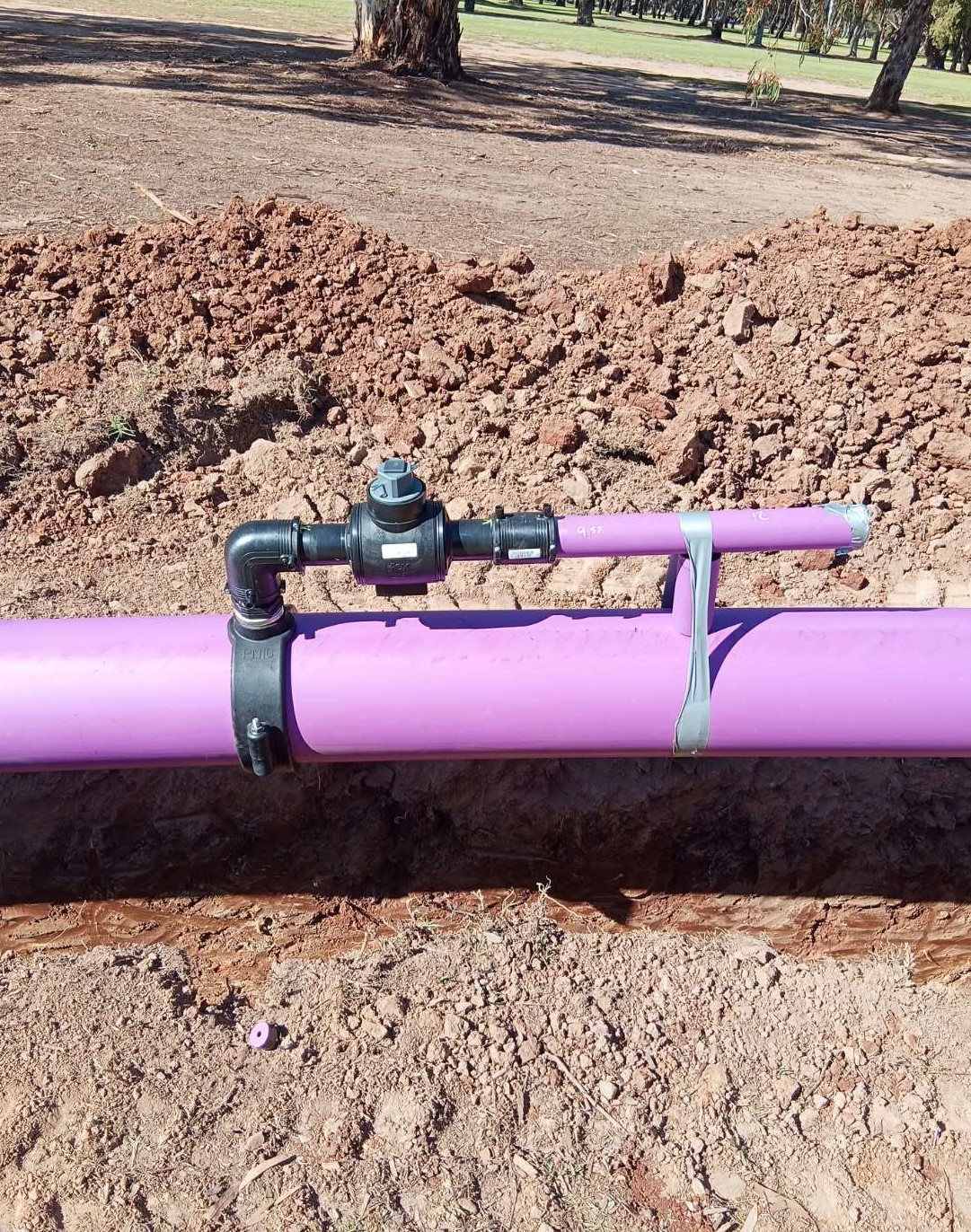

(Lateral valves control the flow of water to individual sprinklers on each hole, allowing precise irrigation of specific areas such as greens and tees. The mainline is the primary water pipe that supplies the course’s irrigation system.)
This is subject to weather and ground conditions.

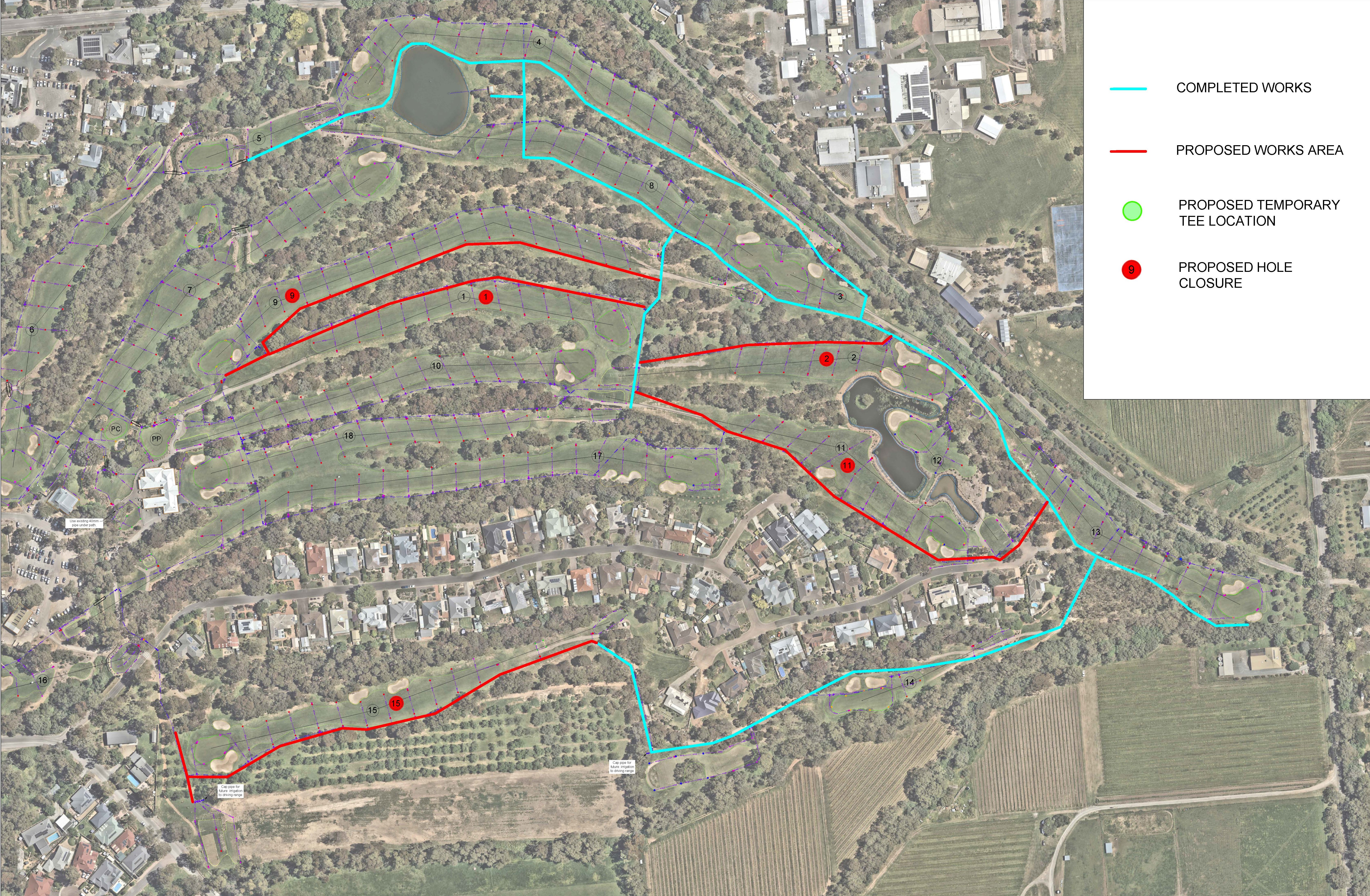

During construction, we’ll keep disruption to a minimum, all 18 holes will remain open for weekend competitions, and no more than three holes will be closed at any one time on weekdays.
Proposed works week commencing 7 July 25.pdf(PDF, 7MB)
